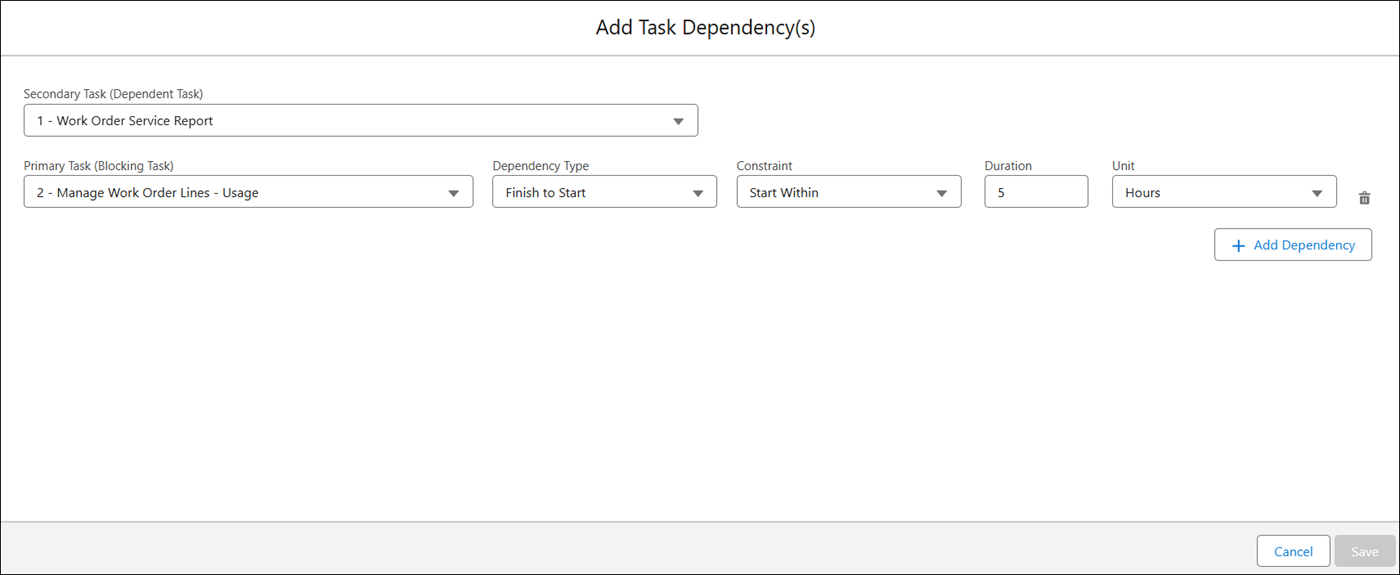

|
Field
|
Description
|
||
|---|---|---|---|
|
Primary Task (Blocking Task)
|
Select the primary (blocking task) task from the drop-down that controls when the dependent task can start or finish. This controls the order of execution.
This field is mandatory to add the dependency.
You can add multiple dependencies for the Secondary Task (Dependent Task).
In the drop-down, the sequence numbers of tasks are displayed along with the task names in ascending order.
|
||
|
Dependency Type
|
Select how the dependent task is related to the primary task. The following are various dependency types:
• Finish to Start: The secondary task starts after the primary task finishes.
• Start to Start: The secondary task starts after the primary task starts.
• Finish to Finish: The secondary task finishes after the primary task finishes.
• Start to Finish: The secondary task finishes after the primary task starts.
|
||
|
Constraint
|
(Optional) Select a time-based condition that controls when the dependent task must start or finish relative to the primary task.
You can configure the following scheduling constraints based on dependency type:
• Finish to Start and Start to Start: Start Within, Start After, and Must Start
• Finish to Finish and Start to Finish: Finish Within, Finish After, and Must Finish
By default, the Constraints is set to None.
|
||
|
Duration and Unit
|
If the Constraints is selected, enter the Duration and select the Unit (Hours, Minutes, or Days) to define the time-based condition.
When the Constraints is selected, it is mandatory to specify Duration and Unit fields.
|
