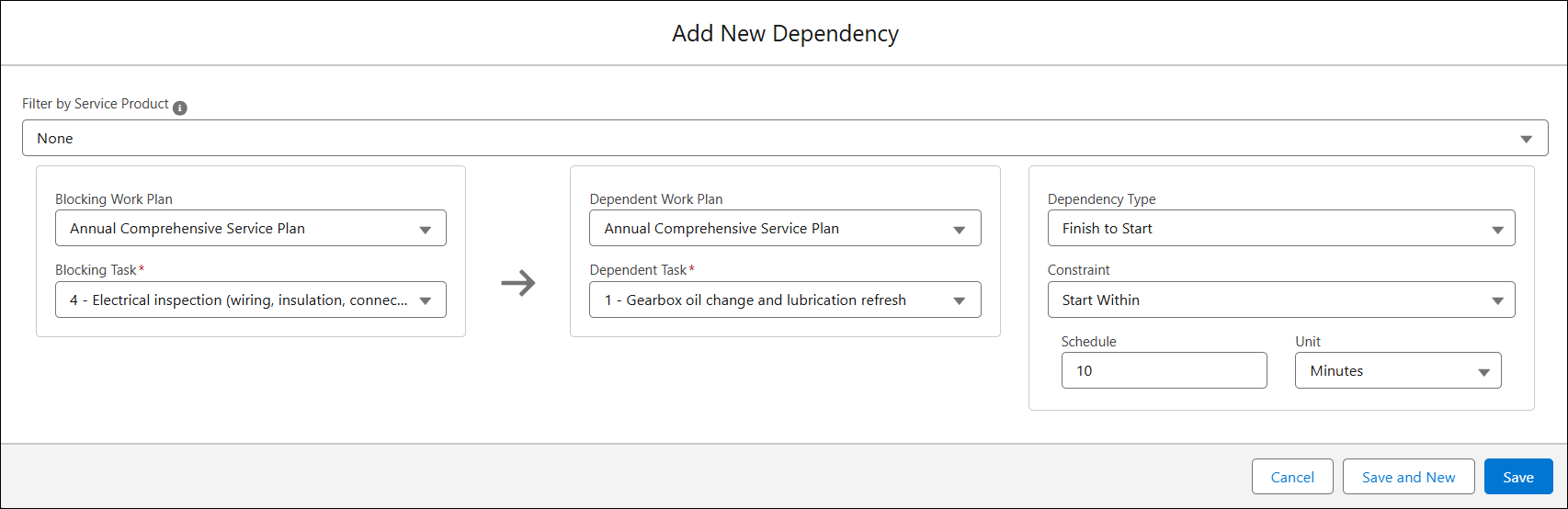

|
Prerequisite
|
|---|
|
You must have Create permission on the Work Order Dependencies object to add task dependencies.
|

|
Field
|
Description
|
||
|---|---|---|---|
|
Filter by Service Product
|
Select the required Service Product added to the Work Order.
This filters the available work plans in Blocking Work Plan and Dependent Work Plan fields based on the selected Service Product and helps narrow down relevant dependencies.
This field is optional. If no Service Product is selected, then all Work Plans associated with the Work Order are available for selection.
|
||
|
Blocking Work Plan
|
Select the Work Plan that includes the task you want to select as a primary or blocking task.
To add General tasks, select No Work Plan option from the drop-down.
|
||
|
Blocking Task
|
Select the task that must be completed or started before the dependent task can proceed. This is a mandatory field.
This field is disabled if the Blocking Work Plan is not selected.
|
||
|
Dependent Work Plan
|
Select the Work Plan that includes the task for which you want to add a dependency.
To add General tasks, select No Work Plan option from the drop-down.
|
||
|
Dependent Task
|
Select the task that depends on the blocking task. This field is mandatory.
This field is disabled if the Dependent Work Plan is not selected.
|
||
|
Dependency Type
|
Select how the dependent task is related to the blocking task. The following are various dependency types:
• Finish to Start: The secondary task starts after the blocking task finishes.
• Start to Start: The secondary task starts after the blocking task starts.
• Finish to Finish: The secondary task finishes after the blocking task finishes.
• Start to Finish: The secondary task finishes after the blocking task starts.
|
||
|
Constraint
|
(Optional) Select a time-based condition that controls when the dependent task must start or finish relative to the blocking task.
You can set the following scheduling constraints based on dependency type:
• Finish to Start and Start to Start: Start Within, Start After, and Must Start
• Finish to Finish and Start to Finish: Finish Within, Finish After, and Must Finish
By default, the Constraint is set to None.
|
||
|
Schedule
|
Enter the time offset or duration associated with the selected constraint (for example, delay or buffer time).
|
||
|
Unit
|
Specifies the unit of time for the schedule value. The Unit can be Hours, Minutes, or Days.
|
|
|
• In the Blocking Work Plan and Dependent Work Plan, you can either select the same Work Plan or different Work Plans based on your requirements.
• You cannot select the same task in the Blocking Task and Dependent Task fields.
• If you are creating dependencies between two different Work Plans, the Dependency Type is always set to Finish to Start and you cannot modify it.
|
